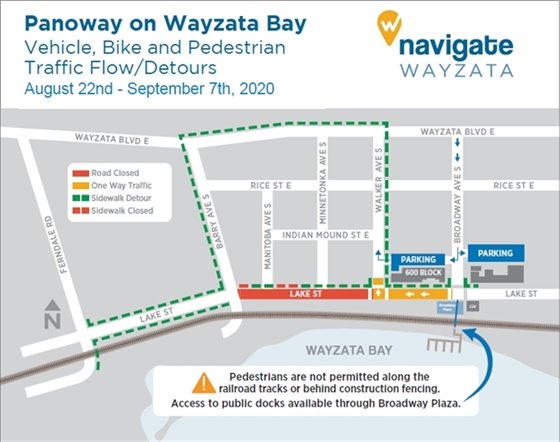

Updated Construction Milestones
As the project nears substantial completion, the following updated important milestones are anticipated:
- Pave bike trail 8/31/2020
- Pave base course from Barry to Manitoba 9/7/2020
- Pave wear course from Broadway to Barry 9/8/2020
- Stripe Lake Street and bike trail 9/9/2020-9/10/2020
- Open Lake Street completely 9/11/2020
- Plaza area open to the public 9/11/2020 (some minor work in the plaza will occur after 9/11, see below)
After Lake Street opens, important but minimal work will still need to be completed including installing metal fins on the exterior of the restroom building, installing the catenary lighting system near the restroom building, assembling site furnishings (chairs, tables, bike racks, etc.), and completing work adjacent to the railroad crossings at Barry and Ferndale.
